In the execution of complex, multi-million-dollar construction and infrastructure projects across the Gulf Cooperation Council (GCC), a project’s financial success is determined long before the first shovel hits the ground. At the center of this contractual ecosystem is the electrical engineering consulting firm, which serves to align technical execution with commercial safety. The primary legal and technical document used to enforce this alignment is the electrical scope of work (SoW).
Far too often, developers and main contractors treat the SoW electrical engineering document as an afterthought, relying on generic templates or copy-pasted clauses. This ambiguity is highly dangerous. Vague wording in the SoW is the single largest driver of costly scope creep, massive variation claims, and prolonged litigation in GCC megaprojects. When technical boundaries are unclear, contractors will inevitably exploit the gaps, leaving the developer to absorb the financial shock. Writing an ironclad Scope of Work is the most effective shield against these disputes, ensuring that every project participant understands exactly what is required of them.
Defining the Battery Limits (Demarcation Points)

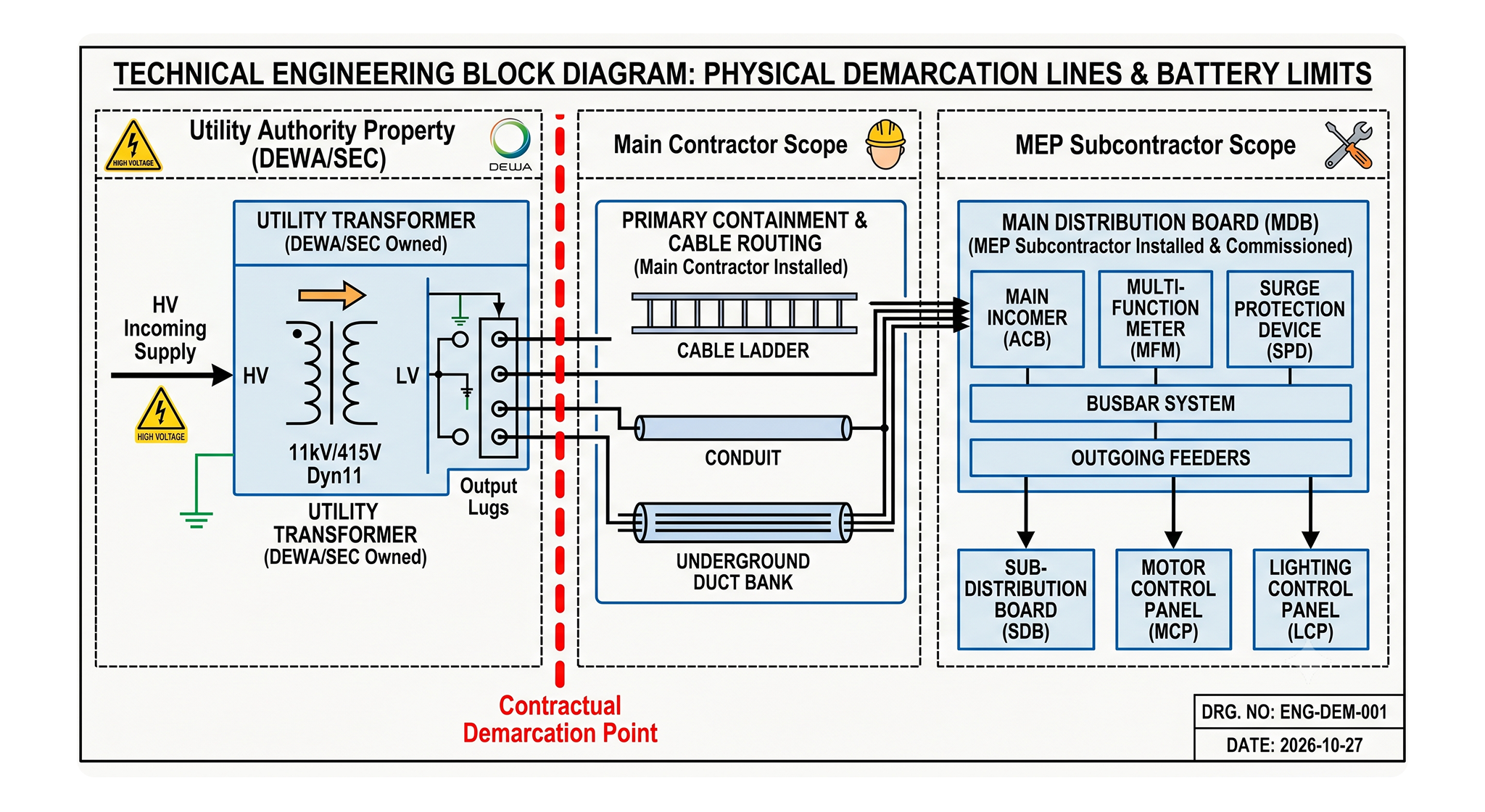

Disputes do not usually occur within the core of an electrical installation; they happen at the boundaries. To prevent finger-pointing between contractors, the SoW must explicitly define the exact physical and electrical boundary lines, known as the battery limits.
The SoW must leave zero room for interpretation regarding the electrical demarcation point. For example:
- Utility Interface: Does the electrical subcontractor’s scope end at the primary lugs of the utility-supplied transformer, or are they responsible for the high-voltage excavation, concrete duct banks, and $11\text{ kV}$ trenching all the way back to the municipal property line?
- Physical Terminations: When terminating a heavy feeder cable into a chiller control panel, does the electrical contractor merely pull the cable to the panel, or are they responsible for the compression lugs, glanding, terminating, and final torque testing?
Specifying these physical battery limits electrical parameters prevents costly misunderstandings during the construction phase.

Naming Specific Codes and Utility Standards
A common and highly dangerous practice in SoW writing is the use of lazy, generic phrases such as “the installation must be completed in accordance with all local laws and regulations.” This is an invitation for disputes.
Contractors will interpret “local regulations” in the most minimalist and cost-effective way possible. A professional SoW must explicitly list every single code and utility guideline that governs the installation.
- The Specifics: For a project in the UAE, the contract must cite the “DEWA Regulations for Electrical Installations 2020” or the specific “ADDC Electricity Wiring Regulations.”
- Power Quality Standards: The SoW must name international standards like IEEE 519 (for harmonic control) and relevant SASO standards if operating in Saudi Arabia.
Explicitly naming these guidelines elevates the electrical standards SoW to a legally binding requirement, ensuring that the contractor cannot claim ignorance when forced to correct a non-compliant installation during the utility compliance contract review.
Detailing Exact Deliverables (Drawings and Studies)
An electrical installation is only as good as the engineering documentation that supports it. To prevent contractors from charging massive premiums for “extra” engineering work, every single drawing, model, and calculation study must be itemized as a mandatory deliverable in the SoW.
The SoW must clearly define the required SoW technical documentation and electrical engineering deliverables, specifying:
- Analytical Studies: Load Flow studies, Short Circuit analysis, Protective Device Coordination studies, and Arc Flash hazard assessments, stating exactly which software (e.g., ETAP or DIgSILENT) must be used.
- Drafting and Modeling: The exact level of Building Information Modeling required (e.g., BIM LOD 400 or LOD 500 models) to ensure clash-free coordination.
- As-Built Records: Tabulated cable schedules, verified wiring schematics, and physical as-built layouts.
Itemizing these deliverables prevents the contractor from arguing that advanced system studies are “outside the basic scope” and charging a hefty variation fee to produce them.
Clarity on Procurement and Approved Vendor Lists (AVL)
A major source of conflict on-site occurs when a contractor attempts to substitute high-quality, specified materials for cheaper, substandard alternatives to protect their profit margins.
The SoW must explicitly state the rules of procurement. By integrating a strict Electrical Plant Procurement framework directly into the contract, the developer retains absolute control over material quality.
- Enforcing the AVL: The SoW must mandate that all major equipment—including transformers, medium-voltage switchgear, cables, and final distribution boards—be sourced exclusively from the utility’s specific approved vendor list GCC (AVL). The contract must state that any material procured from a non-approved vendor without prior, written engineering approval will be rejected at the contractor’s sole expense, eliminating the risk of unapproved material substitutions during electrical procurement SoW execution.
Defining Testing and Commissioning Responsibilities
There is a massive physical and technical difference between “completing an installation” and “commissioning a system.” Vague commissioning terms in the SoW are a prime source of project delay.
The SoW must explicitly divide the FAT SAT responsibilities and outline the electrical commissioning SoW milestones:
- Factory Acceptance Testing (FAT): Who pays for the travel and lodging of the client’s and utility’s engineers to witness the testing of custom switchgear at the factory?
- Site Acceptance Testing (SAT): Who provides the specialized testing equipment, the calibrated relays, and the high-voltage Megger test units?
- Load Bank Testing: Who is contractually obligated to procure, connect, fuel, and operate the temporary load banks required to test the emergency standby generator systems under full load?
- Utility Coordination: Who physically books, coordinates, and manages the final utility site inspection?
Clearly assigning these tasks ensures that commissioning is a structured, planned sequence rather than a chaotic rush at the end of the build.
The Interface Matrix: Managing MEP Clashes
An MEP (Mechanical, Electrical, Plumbing) project is a crowded environment. If the boundary lines between the electrical contractor and the mechanical contractor are not perfectly drawn, massive disputes will occur.
The absolute best tool to prevent these conflicts is a comprehensive MEP interface matrix. This matrix is a detailed table that maps out the exact boundary lines for overlapping systems.
- The Chiller Example: Who mounts the Variable Frequency Drive (VFD) for a massive HVAC chiller? Who pulls the heavy power cables to the VFD? Who pulls the low-voltage control and sensor wiring from the VFD back to the Building Management System (BMS)?
By addressing these questions in a matrix, you ensure seamless electrical mechanical coordination, eliminating the “grey zones” where work is either double-scoped or completely missed.

Handling Variations, Changes, and Value Engineering
No project is built exactly as it was drawn on Day 1. Design changes, site conditions, and value engineering proposals will inevitably alter the initial plan.
The SoW must establish a rigid, non-negotiable protocol for managing an electrical scope variation.
- Pre-Agreed Unit Rates: The contract must include a schedule of unit rates (e.g., a fixed price per meter of specific cable tray or size of cable pulled). This ensures that if a design change requires routing an extra feeder, the price is calculated based on pre-agreed rates rather than a highly inflated, emergency variation claim.
- Value Engineering Rules: Any value engineering SoW proposal submitted by the contractor to save costs must be backed by rigorous technical calculations proving that the proposed change does not compromise the safety, life-safety compliance, or long-term reliability of the system.
Operations, Maintenance, and Training (O&M)
A project is not truly complete when the power is switched on. The final transition of the live, energized building to the facility management (FM) team is a critical operational phase.
The SoW must clearly define the closeout and facility management handover requirements:
- O&M Manuals: Specify the exact digital and physical formats required for all electrical O&M manuals, including certified test reports, manufacturer datasheets, and step-by-step operating procedures.
- Training Hours: Stipulate the exact minimum number of classroom and on-site training hours the contractor must provide to the FM team (e.g., 40 hours of hands-on training for the medium-voltage switchgear operations and emergency generator synchronization procedures).
- Spare Parts: List the exact inventory of critical spare parts (fuses, indicator bulbs, breaker spring-charging handles) the contractor must leave behind on site.
Frequently Asked Questions (FAQ)
1. What are “battery limits” in an electrical contract?
Battery limits represent the physical and contractual boundary lines where one contractor’s responsibility ends and another’s begins. For example, the battery limit might be defined as the output terminals of the main circuit breaker, meaning the subcontractor is responsible for everything downstream of that breaker, but nothing upstream.
2. Why is an MEP Interface Matrix necessary?
An MEP Interface Matrix is necessary because many modern systems (like HVAC chillers, fire pumps, and smart lighting) require both mechanical and electrical expertise. Without a matrix, contractors will clash over who is responsible for mounting equipment, running power cables, pulling low-voltage control wires, and conducting final commissioning.
3. How does itemizing engineering deliverables save money?
If you simply ask a contractor to “install the system,” they will charge extra for any advanced engineering deliverables (like ETAP load flow studies, short circuit calculations, or BIM 3D coordination models) claiming they are “outside the basic installation scope.” Itemizing these deliverables in the SoW forces the contractor to include their costs in the initial bid.
4. What is the danger of using the phrase “in accordance with local regulations”?
This phrase is too vague. Different local utility departments (like DEWA, ADDC, or SEC) have varying and highly specific requirements. A contractor will always interpret a vague clause in the cheapest way possible. Naming the exact codes, revisions, and standards ensures you can legally hold the contractor to those specific technical benchmarks.
5. Who is responsible for providing load banks during generator testing?
This must be explicitly stated in the SoW. Temporary load banks, their physical connection cables, and the fuel required to run them are highly expensive. If the SoW does not explicitly assign the procurement and operation of load banks to the contractor, they will charge it as a massive variation claim during the commissioning phase.
Ironclad Engineering Contracts
Writing an exceptional electrical Scope of Work is not merely an administrative chore; it is a critical engineering discipline. A meticulously structured SoW acts as a shield, protecting the project’s budget, keeping construction schedules on track, and safeguarding the long-term operational integrity of the completed facility. By eliminating technical ambiguities, defining precise battery limits, enforcing approved vendor lists, and structuring detailed interface matrices, you prevent disputes before they can ever manifest on-site.
Relying on generic templates or uncoordinated contracts is a direct path to scope creep, massive variation claims, and legal gridlock.
Need to draft or review a megaproject SoW?
Do not leave your facility’s financial and technical safety to chance or contractor interpretation. Partner with an expert electrical engineering consulting firm to eliminate contractual ambiguities. Elecwatts provides the certified technical due diligence, Project Lead Engineering & Management services, and comprehensive electrical contract review required to design, coordinate, and secure your high-stakes infrastructure assets flawlessly.
Contact Elecwatts today to secure the contractual and engineering integrity of your next electrical project.
